Skip to content

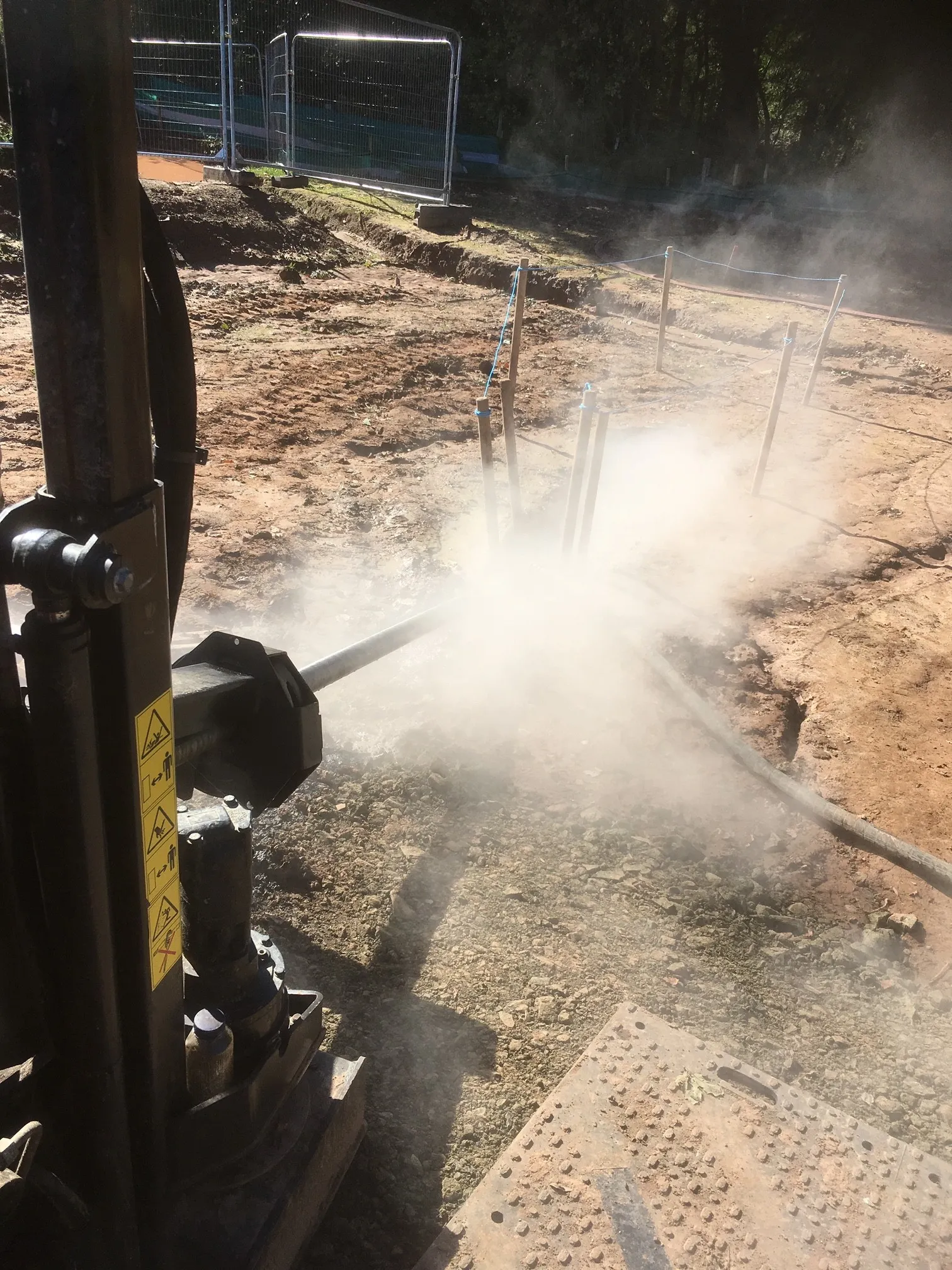

Directional drilling rig boring the 900mm outfall through rock at Hopton

Case Study · Gravity Drainage

900mm drainage outfall, drilled through rock

On a former ironworks at Hopton, we directional-drilled a 900mm gravity outfall down a steep, wooded valley side to the brook, the crossing the design team had expected to tunnel. Drilling it instead saved the client around £1 million.

  • 900mm SDR 17 outfall
  • Drilled through rock
  • ~£1m saved vs tunnelling
  • Completed 2018

The job

An outfall everyone expected to tunnel

Severn Trent needed a new 900mm gravity drainage outfall installed for principal contractor Barhale/NMC at Hopton. The line ran down a steep, heavily wooded valley side (mature oak and ash the whole way) to discharge near Hopton Brook.

Open-cut was a non-starter. A deep trench for a 900mm pipe down that slope, through the trees and rock, would have been hugely disruptive and expensive. So the scheme had been priced to betunnelled or auger bored. We were brought in to look at whether it could be directional drilled instead.

Two things made it hard. The ground was largely “strong” rock. And because gravity drainage has to run to falls (a continuous, designed gradient, not just “from A to B”), the bore had to be steered to an exact profile the whole way down to the outfall.

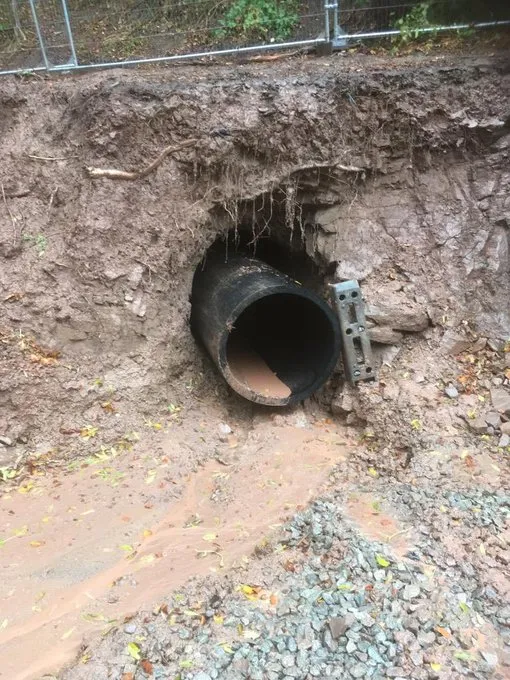

The finished 900mm outfall pipe emerging from the rock face at Hopton, with water already running through it
The end result. The 900mm outfall drilled in and already running, the crossing the design team had expected to tunnel.

Project at a glance

ClientSevern Trent
Principal contractorBarhale / NMC
LocationHopton, near Kidderminster (DY14), a former ironworks site beside Hopton Brook
Scope900mm O.D SDR 17 gravity drainage outfall, drilled to falls
Pipe900mm O.D SDR 17 HDPE, supplied, butt-fusion welded and de-beaded
MethodHorizontal directional drilling through rock, in place of the proposed tunnel / auger bore
FallPipe invert dropped about 15m over the ~100m run, following a ~22m fall in ground level to the watercourse
BoreCurved bore reamed to 1175mm, launch / drive / reception pits
RigDitch Witch JT60 (All Terrain rock system)
GroundLargely “strong” rock, plus buried iron, steel cable and bar from the old works
ProgrammeAbout 3 weeks on site
OutcomeDelivered within 10% of the quoted cost despite hidden steel; ~£1m saved vs tunnelling
Year2018

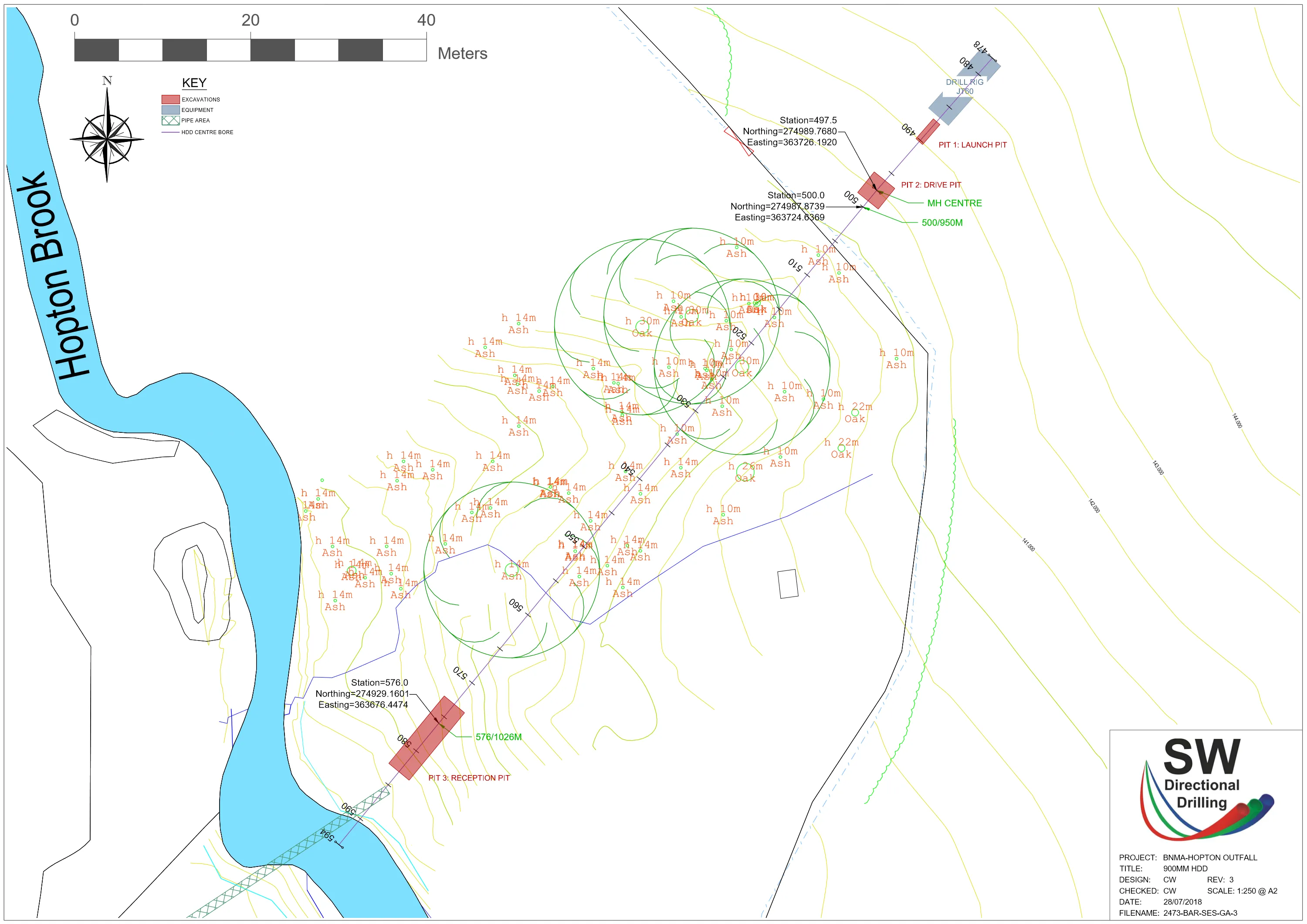

Our REV 3 general arrangement, designed and checked in-house, July 2018.

The solution

Drilled, not tunnelled. The saving that came with it

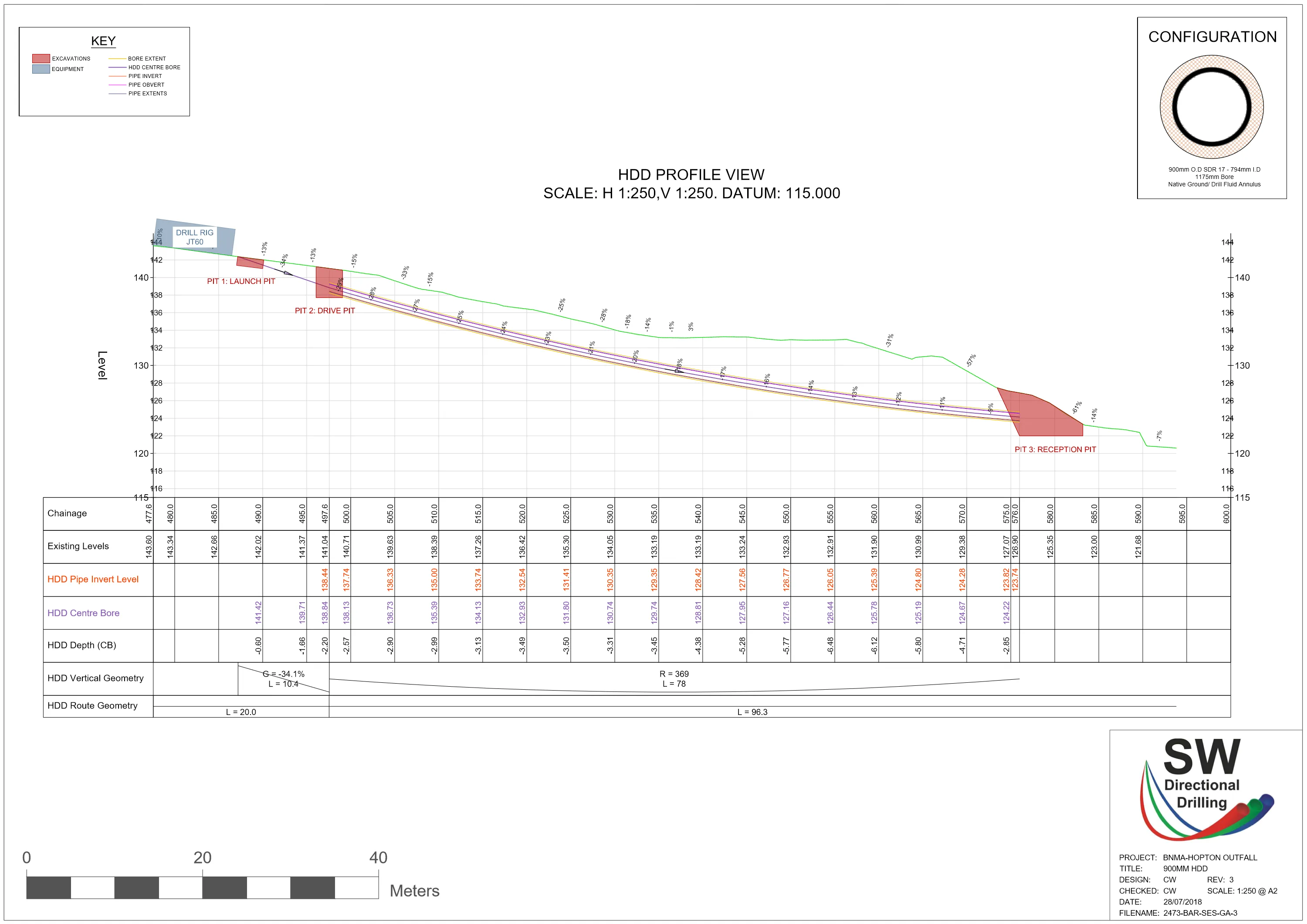

HDD profile drawing of the Hopton 900mm outfall. A curved bore descending the valley side to the reception pit by Hopton Brook
Our HDD profile for the crossing. The bore drops down the valley side on a designed vertical curve (radius 369m) to the reception pit by the brook, with launch, drive and reception pits set out along the line. Held to a controlled gradient, it delivers the outfall to falls.

The key was a designed curve in the bore. The pipe invert had to drop about 15 metres over the roughly 100-metre run, following a fall in ground level of some 22 metres down to the watercourse. Left as a single steep, straight grade pointing down the hill, it would have been very difficult to pull a 900mm pipe in. By easing the profile through a curve we made the crossing drillable and pullable, so we could install it by HDD rather than tunnel it.

And that is where the money was saved. It was not the curve itself that saved the £1 million; it was being able to drill the outfall at all instead of tunnelling it. Tunnelling or auger boring down that slope would have meant far more groundwork, far more time and far more cost. Directional drilling took all of that out of the job. We drilled it to falls, reamed the bore to 1175mm and pulled in the 900mm SDR 17 pipe with a Ditch Witch JT60 All Terrain rock rig.

The pipe was ours to deliver too. We supplied the 900mm HDPE, butt-fusion welded it into one continuous string on site and de-beaded it, taking the internal weld bead back out of each joint so the finished outfall runs clean and holds its bore for the life of the asset.

The complication

A former ironworks fights back

Hopton had been an ironworks, and the ground had not forgotten it. Partway through the bore we started hitting what the site history hadn't fully warned us about. Buried iron, steel cable and steel bar left in the ground from the works. Steel is about the worst thing to meet with rock tooling. It wears cutters down and chews up a reamer.

There was no clean way around it. It was simply a case of adapting the tooling and throwing more tooling at it until the bore was through. For one of the final passes we built a custom winged reamer in-house that cut both forwards and backwards and let spoil through the middle, an unconventional choice, specifically so it wouldn't lock up on the metal in the bore. It worked perfectly. Twenty years of building and modifying our own drilling kit is exactly what lets us keep going when a job turns like this, rather than standing the rig down to wait on parts.

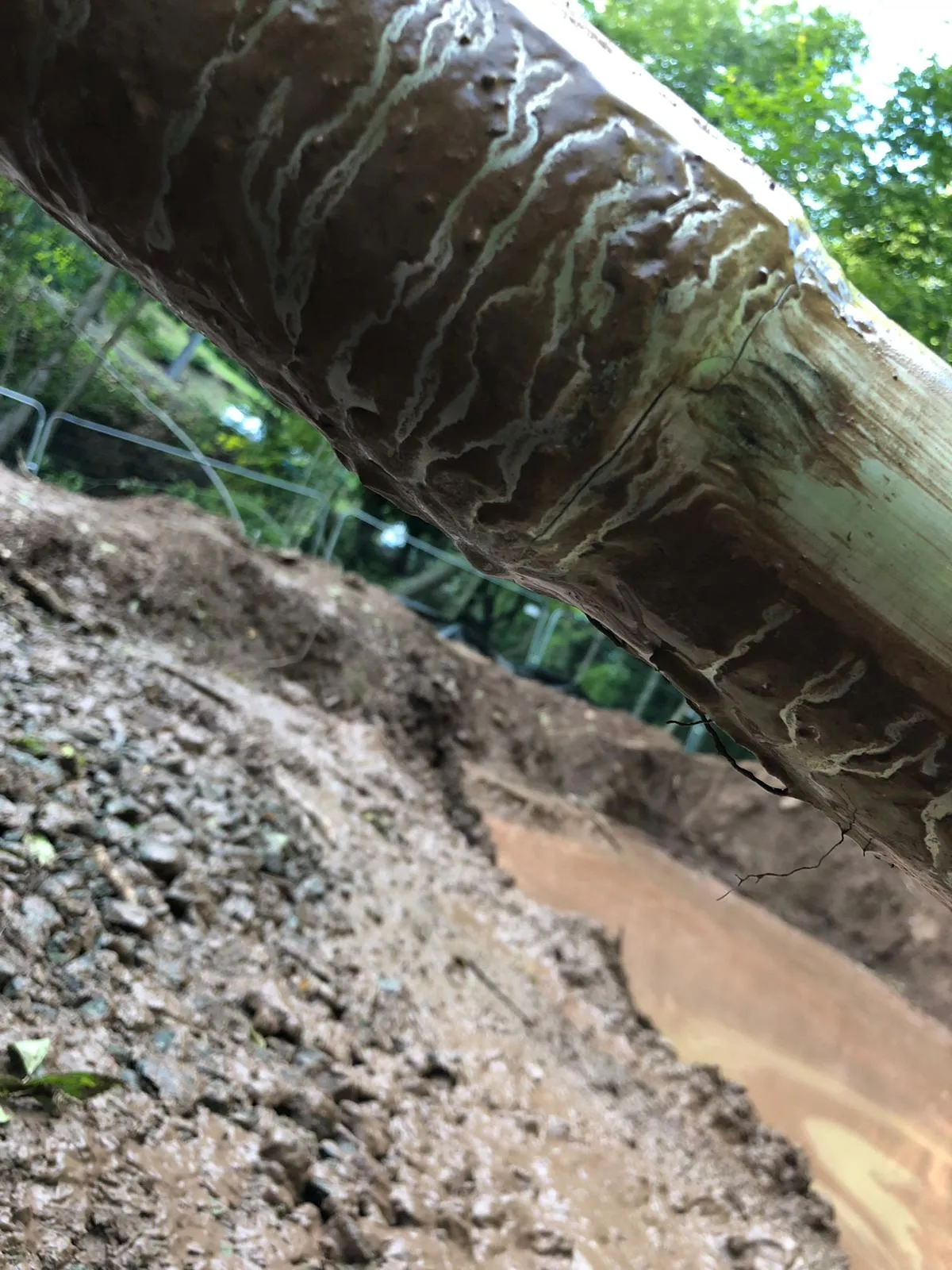

We inspected the gear constantly, too. We check our equipment as a matter of course, but on a job like this we were checking everything, all the time. Catching something like a cracked drill rod early, before it lets go downhole, is the difference between finishing the bore and abandoning it.

Despite the hidden steel and the damage it did, we brought the job in within 10% of the quoted price and off site in about three weeks.

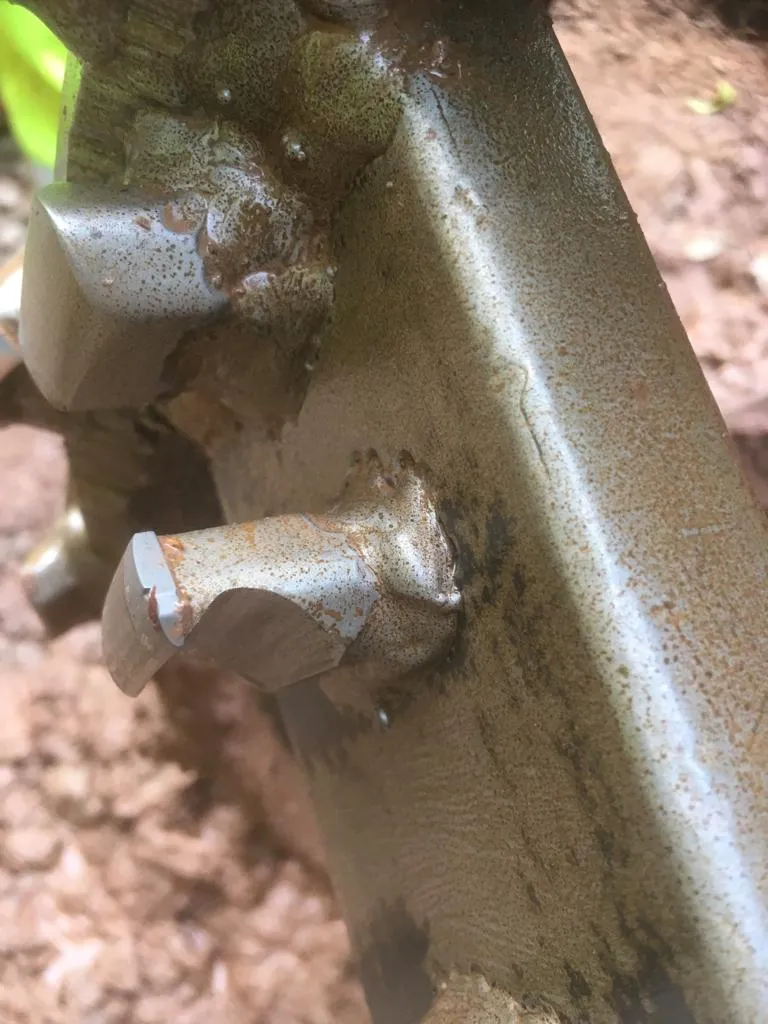

Reamer cutter worn flat after grinding against buried metal in the Hopton bore
A carbide cutter worn right down, the kind of wear you get grinding against buried metal, not rock.

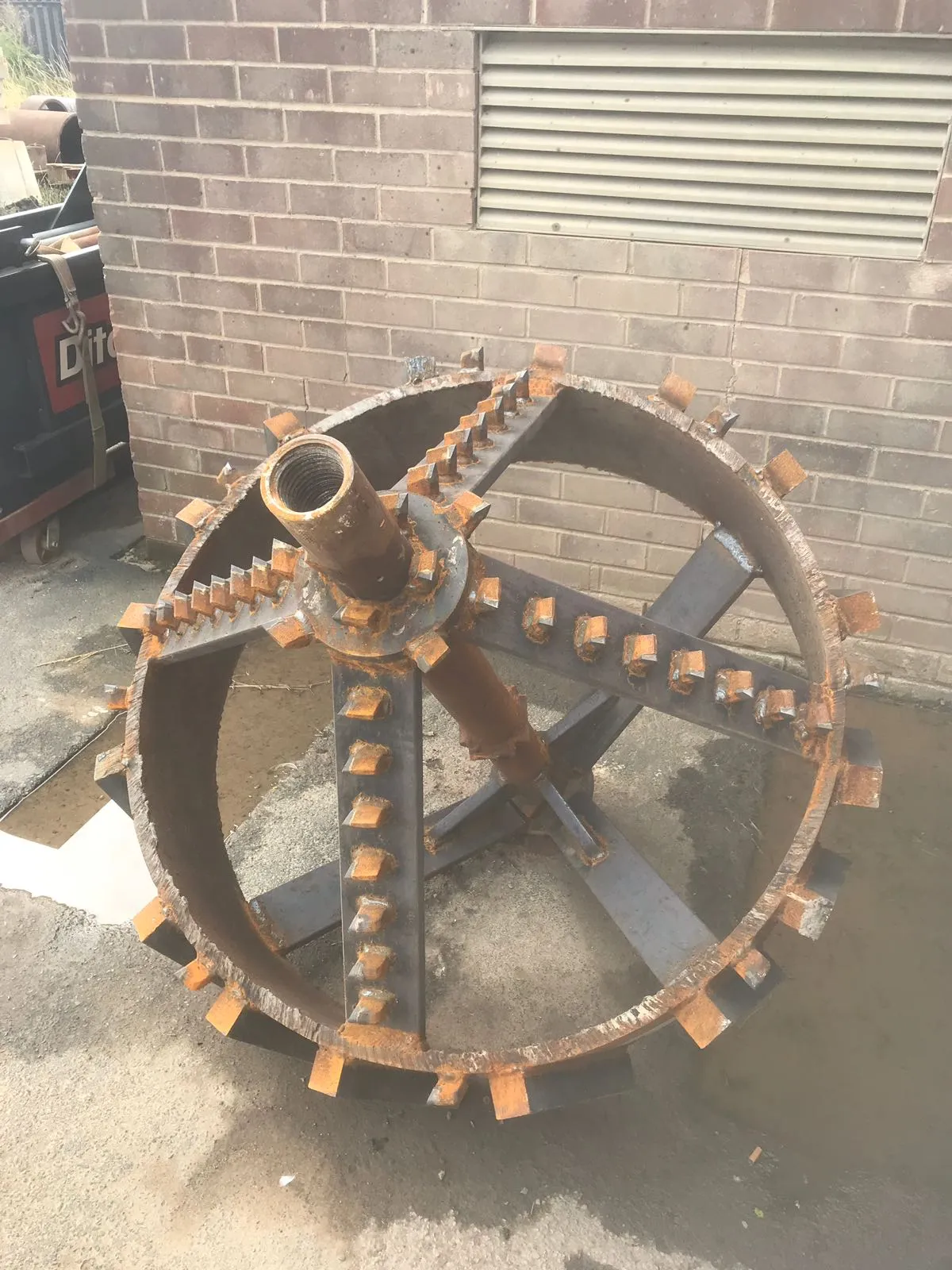

Custom in-house winged reamer built for a final reaming phase of the Hopton bore
A custom winged reamer we built in-house for a final pass. It reams both forwards and backwards and lets spoil pass through the middle, an unconventional choice to avoid locking up on the buried metal, and it worked perfectly.

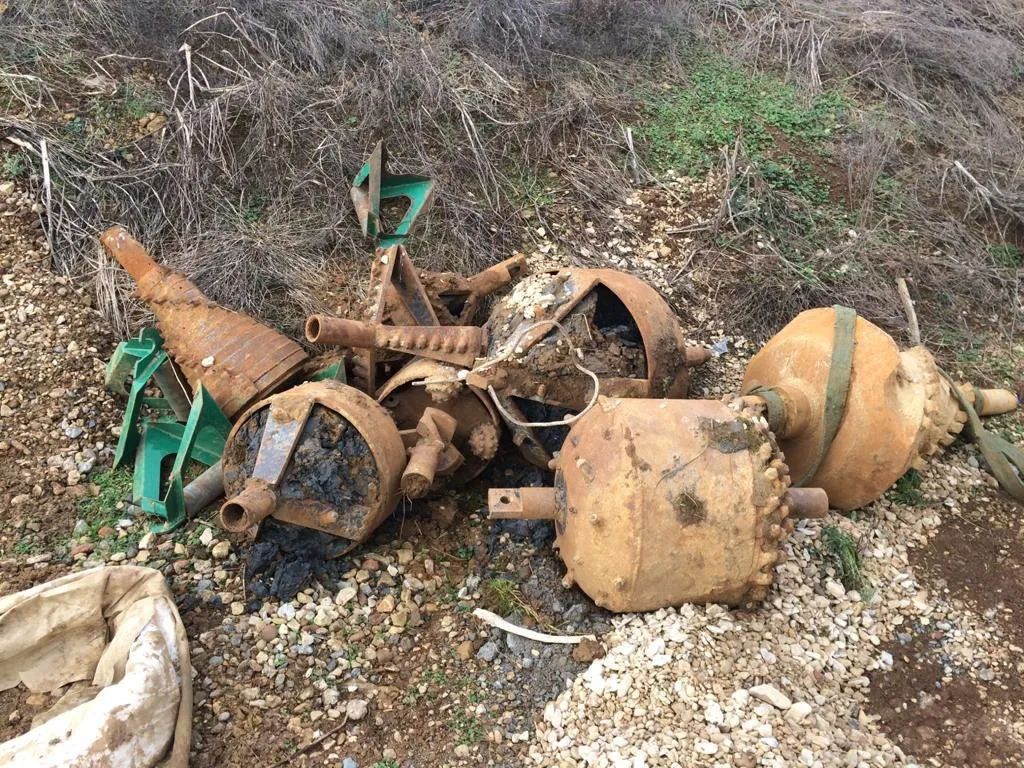

A selection of rock reamers and hole openers mobilised for the Hopton bore
Some of the reamers and hole openers we took to the job, a range of tooling ready for the rock and whatever the old works had left in the ground.

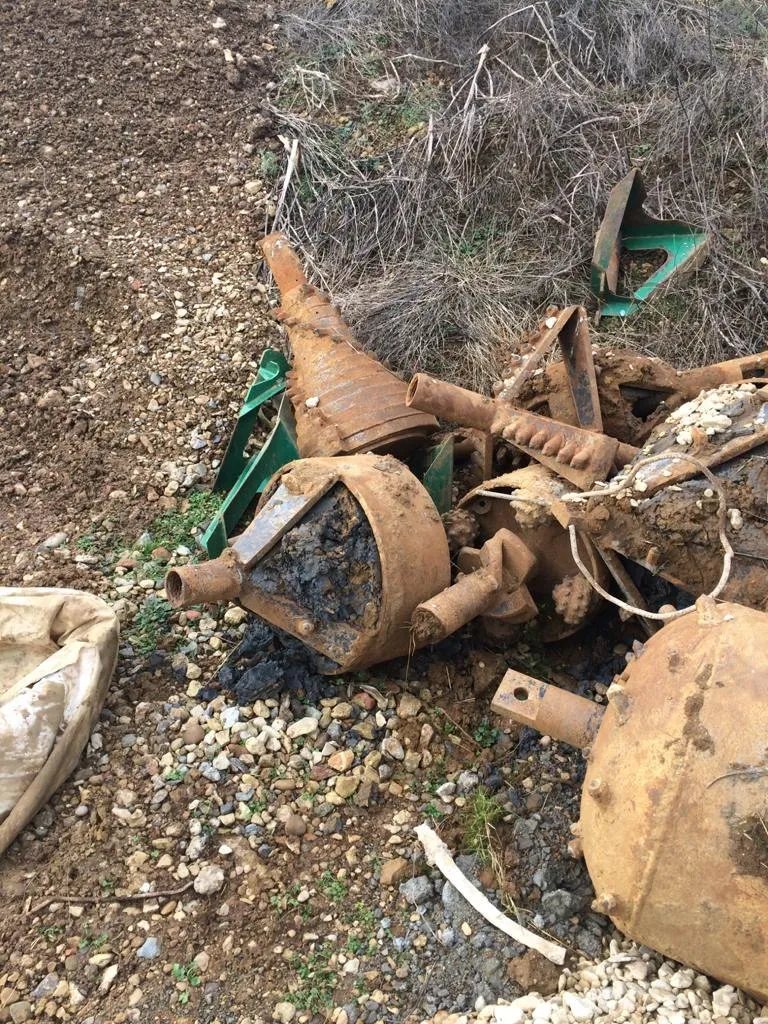

Rock reamers laid out on site for the Hopton crossing
Carrying the right range of tooling is what keeps a bore like this moving when the ground turns.

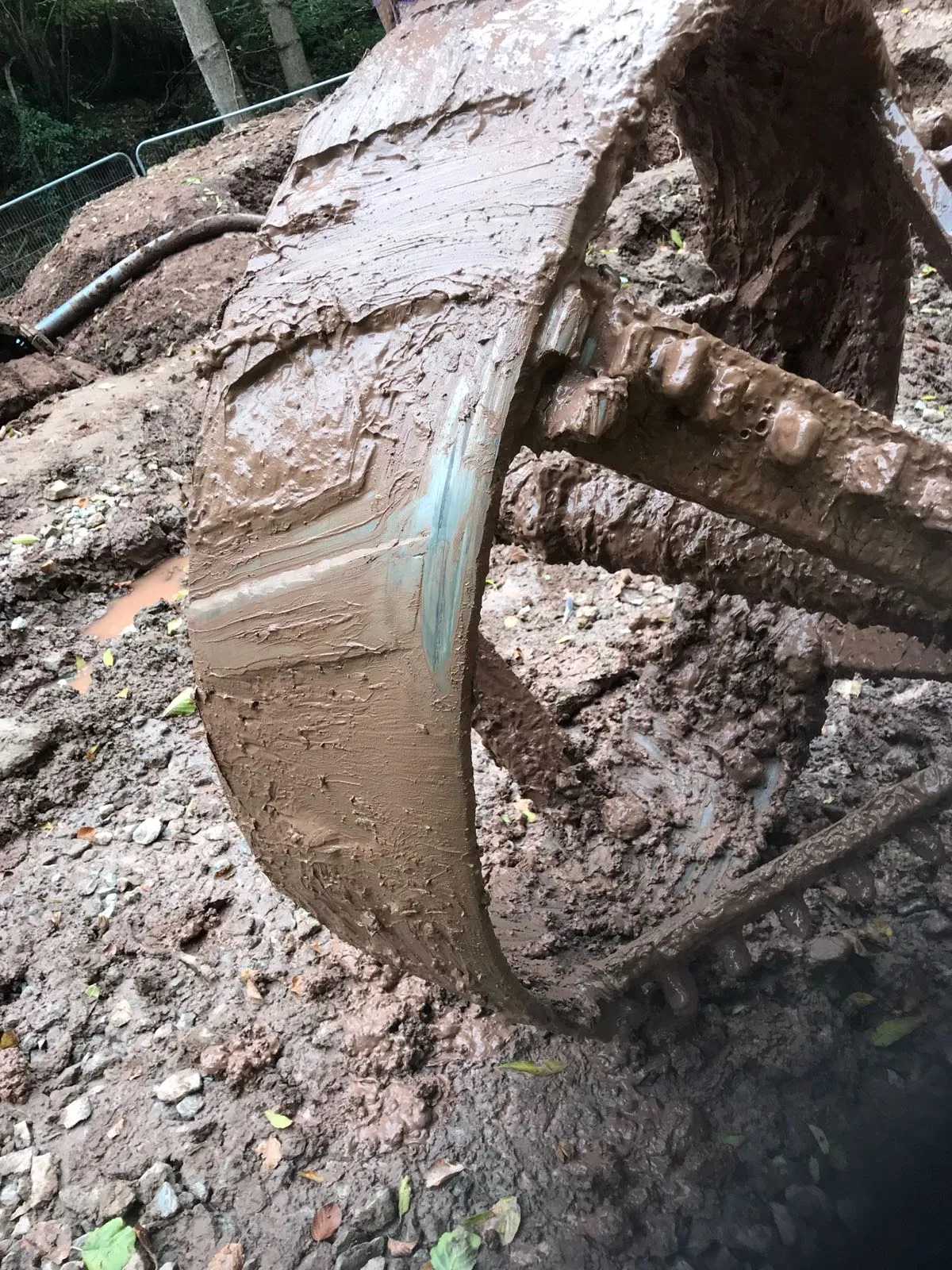

On site

The crossing in pictures

The outcome

One outfall, drilled to falls, ~£1m saved

A 900mm gravity outfall delivered to its designed fall, through strong rock and a buried ironworks, by directional drilling instead of a tunnel, on programme in about three weeks and within 10% of the quoted cost. It is the clearest example we have of why it pays to ask whether a crossing can be drilled before it is priced to be tunnelled.

Questions answered

Questions about this project

Can 900mm drainage really be installed by directional drilling?

Yes. At Hopton we installed a 900mm outer-diameter SDR 17 gravity outfall by directional drilling, drilled to falls, where the original proposal was to tunnel or auger bore it. Large-diameter gravity drainage is one of the things we specialise in. The bore is steered to a designed gradient so the finished pipe holds its fall the whole way. See our trenchless drainage service for how we do it.

How can directional drilling save around £1 million against tunnelling?

At Hopton the saving came from being able to drill the crossing at all rather than tunnel it. Tunnelling or auger boring the outfall down a steep, wooded valley side to the brook would have meant far more groundwork, shafts and time. A designed curve in the bore made directional drilling possible and let us pull the 900mm pipe in, which avoided the tunnel altogether and took the cost out of the job.

Can you directional drill through rock and buried obstructions?

Yes. The Hopton ground was largely strong rock, and being a former ironworks it also hid iron, steel cable and bar that we only found once we were partway through. We drilled it with a Ditch Witch All Terrain rock system and, when the steel started damaging tooling, adapted and added tooling to push the bore through. We still finished within 10% of the quoted price. See rock directional drilling for more.

Got a crossing that's been priced to tunnel?

Send us your drawings and levels. If it can be directional drilled instead (through rock, to falls, or around obstructions), we'll tell you honestly, and what it should save.
